Updated 7 August 2026 with full-year 2025 and H1 2026 delivery data. The version of this page published in 2025 is examined, and corrected, in a section below.

Dubai published a lot of alarming supply forecasts last year. Most shared one assumption: that the difference between homes scheduled for delivery and homes actually delivered was a problem developing in real time, driven by strained contractors and slow supply chains.

A year of data says otherwise. The share arriving on schedule has barely moved, while construction itself has got faster. That combination changes what an owner should do about it.

The number that has not moved

Property consultancy Cavendish Maxwell tracks Dubai residential completions against what was scheduled at the start of each period. The resulting figure, the materialisation rate, is the cleanest measure of whether the city delivers what it promises.

  • Q3 2025: 9,400 homes delivered against 22,800 scheduled, a materialisation rate of 41.3%.1
  • Q1 2026: 12,900 delivered against 30,300 scheduled, 42.3%, and the strongest quarter in three years.2
  • H1 2026: 24,800 delivered, 41.3% of what was scheduled.3

Scheduled versus delivered

Every period measured against what was announced at its start. The grey bar is the promise, the blue bar is what arrived.

  • Q3 2025 41.3%
    Scheduled22,800
    Delivered9,400
  • Full year 2025 48.9%
    Scheduled82,600
    Delivered40,400
  • Q1 2026 42.3%
    Scheduled30,300
    Delivered12,900
  • H2 2026 expected
    Scheduled47,000
    Expected14,000 to 23,500
Cavendish Maxwell / Property Monitor. The H2 2026 range is their projection based on historical materialisation, not a recorded figure. Sources 1 to 4 below.

The delivery rate that did not move

Three readings across a year, through record launches and through a slowdown, all within one percentage point.

  • 41.3%Q3 2025
  • 42.3%Q1 2026
  • 41.3%H1 2026

48.9% is the rate for the whole of 2025, and it sits well above the quarterly readings for a reason: homes that miss one quarter frequently land in the next, so a year of data absorbs what a quarter records as a miss.

Quarterly and annual materialisation rates, Cavendish Maxwell. Sources 1 to 4 below.

Three readings across a year, all within one percentage point. Cavendish Maxwell described the H1 2026 figure as broadly in line with historical trends.3

Read that again. It is the whole article. A rate that stays flat through a boom, through record launches, and through a slowdown is not a symptom. It is the operating condition of the market. For a buyer, that means the moment when the keys arrive and the last instalment falls due is not a risk that might appear: it is the normal shape of an off-plan purchase, and it is why covering the last off-plan instalment without selling is a planning question rather than an emergency one.

What this article said in 2025, and what was wrong with it

This page has been live since 2025. Its earlier version reported the Q3 2025 rate as 42%, which turned out to be almost exactly right, and then drew three conclusions that the following year did not support. Since NEMAX asks readers to act on these numbers, the corrections belong in public.

"58% remain overdue." Not delivered inside a quarter is not the same as late. Schedules are re-based every quarter, and homes that miss one window frequently land in the next. Across the whole of 2025 the annual materialisation rate came in at 48.9%: 40,400 homes delivered against an initial projection of 82,600.4 The annual figure sits well above the quarterly one precisely because much of the shortfall is timing inside the year, not failure.

"Persistent construction-capacity and supply-chain delays." The opposite happened. The average construction cycle for a delivered Dubai home shortened to roughly 880 days in 2025, down from 1,180 days in 2024 and 1,340 days in 2023.1 Builders got materially faster while the on-time share stayed flat. The constraint sits in the schedule rather than on the site: delivery dates are set optimistically at launch, so the gap is designed in before a single foundation is poured.

"If completion rates remain near current levels, around 60% of scheduled supply." That contradicted the same article's own 42%. Real levels run in the low forties per quarter and just under half across a year.

One more number is gone entirely. The earlier version multiplied roughly 70,000 scheduled units by an assumed 30% shortfall rate to produce "about 21,000 buyers affected". Neither input had a source. An estimate built on two guesses is not a finding, and it has been cut rather than updated.

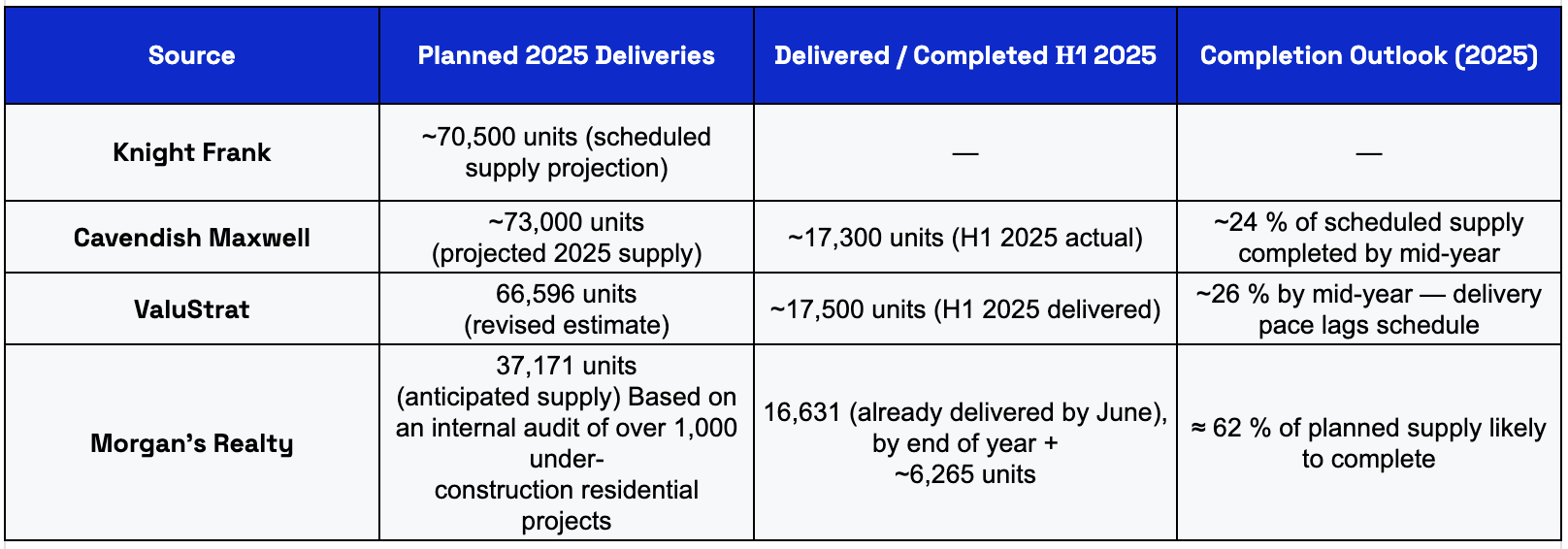

2025 against 2026, side by side

Measure20252026
Delivered, first half17,30024,800 (+37.6%)
Materialisation rate41.3% (Q3), 48.9% (full year)42.3% (Q1), 41.3% (H1)
Apartments delivered, first halfshare of roughly three quarters18,900 (+43%)
Villas and townhouses, first halfremainder5,900 (+22.6%)
New launches, first half102,000 homes across 410 projects28,000 across 124 projects
Average construction cycle~880 daysshortening trend continues

Sources for every figure are listed at the end.1 3 4

Two of those rows deserve attention. Deliveries rose by more than a third. Launches fell by roughly three quarters. Cavendish Maxwell summarised the shift as a market moving from launch-led to delivery-driven.3

From launches to handovers

The same two halves of the year, one against the other. What the market sells fell by roughly three quarters; what it hands over rose by more than a third.

First half 2025
New launches
102,000across 410 projects
Delivered
17,300homes handed over
First half 2026
New launches
28,000across 124 projects
Delivered
24,800homes handed over, up 37.6%

In a launch-led market the money is due at the start, in small booking instalments. In a delivery-driven market it is due at the end, in one large payment, on the day the keys arrive. Dubai has just crossed from one to the other.

Cavendish Maxwell, H1 2026 against H1 2025. Source 3 below.

That phrase has a financial translation. In a launch-led market, most of the money a buyer needs is due at the start, in small booking instalments, and the market's energy sits at the sales stand. In a delivery-driven market, the money is due at the end, in one large payment, at the moment the developer hands over keys. Dubai has just crossed from one to the other.

Why "not delivered" does not mean "overdue"

Three mechanics explain most of the gap, and none of them is a scandal.

Schedules are marketing documents before they are engineering ones. A launch date is announced when a project is sold, years before it is built. Cavendish Maxwell measures against those announced dates, which is the right way to measure and sets the bar high by design.

Phasing splits a project across quarters. A tower handed over in three stages counts as scheduled once and delivered three times.

The contract already anticipates slippage. Dubai's standard sale-and-purchase agreement typically gives a developer a grace window of up to twelve months past the announced date before a buyer's formal remedies open up.5 A home delivered eleven months late is, contractually, on time.

Together these mean "58% of Dubai homes are late" was never the honest reading. The date on a brochure is simply the least reliable number in the transaction, and everything a buyer schedules around it inherits that unreliability.

The gap that did grow

Here is where 2026 genuinely differs from 2025, and it is not the percentage.

For the second half of 2026, roughly 47,000 homes are scheduled for delivery. Based on historical materialisation, the expected actual figure is 14,000 to 23,500.3 For the full year, about 110,500 homes were projected, against a realistic 33,000 to 50,000.4

Hold the percentage constant and grow the pipeline, and the absolute gap grows with it. Roughly 13,000 homes missed their quarter in Q3 2025. The equivalent shortfall now runs into the tens of thousands per half year. Every one of those is a household or an investor whose money was scheduled against a date that moved, and the number of them has never been higher.

Concentration sharpens it further. Around 37% of the homes scheduled for the second half of 2026 sit in six communities: Jumeirah Village Circle, Dubai South, Dubai Science Park, Business Bay, Downtown Dubai and Dubai Healthcare City.3 When several towers in one district hand over in the same quarter, their buyers compete for the same valuers, the same bank processing capacity and, if they sell instead, the same handful of buyers.

Since June 2026 part of that gap has been addressed from the bank's side, though only for some buyers and only on some projects: who actually finances Dubai off-plan in 2026.

The exit that used to work has closed

The 2025 version of this page treated a delayed handover mainly as an inconvenience. It could afford to, because the standard escape route still worked: sell before completion, at a profit. In Q3 2025 Dubai sales prices were rising 16.1% year on year and 4.5% in a single quarter.1 Almost any exit was a good exit.

That door has quietly shut. In H1 2026 average sales prices reached AED 1,639 per square foot, up just 1.9% over the year and down about 2.5% against the previous quarter.3 Transaction volumes fell 14% to 79,300 deals, and total value fell 16% to AED 221.4 billion.3 Rents, meanwhile, rose 7.8%, so holding pays better than selling. This is the same structural story told by what the cash vs bank finance numbers show: the Dubai market rewards whoever can complete a deal, not whoever can price it best.

One indicator moved firmly the other way. Deals closed with bank credit rose to 22,500 transactions worth AED 51.3 billion, up 17.4% year on year, while the market around them shrank.3 More buyers are reaching completion needing outside capital to get there.

So an owner's position at handover in 2026 is narrower than in 2025. Selling into a softening market means accepting a discount at exactly the moment thousands of similar units in the same district hit the resale listings. Waiting is not free either, since off-plan buyers still make up 74.8% of all transactions and the pipeline behind them keeps arriving.3 Where the two dates belong to two different properties, one being sold and one being bought, the timing question has its own mechanics: see how bridge financing works in Dubai.

A year on, the wave has landed. What the delivery numbers look like now, and what a queue of finished units does to the price an owner can actually exit at, is set out in what the delivery wave does to an exit price.

Who carries the timing risk

Not everyone is equally exposed. The pressure concentrates in four places.

Buyers on a back-loaded payment plan. The bigger the final instalment relative to the price, the more a moved date matters.

Anyone whose funding has an expiry date. A bank approval obtained against an expected handover in March is of limited use if the keys arrive in November. Re-approval means re-underwriting, at whatever the terms are then.

Owners who planned to fund one completion with the sale of another asset. Two dates now have to line up, and neither is under their control.

Buyers in the six high-concentration districts. Local resale competition peaks in exactly the quarter their own payment falls due, which is how a solvent buyer ends up selling at a discount. That is one of the routes by which stock reaches the market at a discount, and it is worth understanding how a distressed deal in Dubai actually closes before becoming the seller in one.

Note what is absent from that list: being short of money in general. This is a timing problem for people who own a real asset, which is why the answer is a timing instrument rather than a rescue.

What to plan before the date moves

The practical response follows from the data. If roughly six in ten scheduled homes miss their window in any period, and that has held for a year, handover liquidity is a standing requirement of an off-plan purchase, not a contingency.

Three things are worth doing while the date is still theoretical.

Establish what the property itself can support, before completion. The asset is the strongest thing an owner has at handover, and its capacity can be assessed ahead of the date. Asset-backed co-financing works against the property's value, which is the mechanism described in full in raising capital against your Dubai property.

Give any approval more runway than the developer's date. Build the twelve-month contractual grace window into the plan rather than the brochure date.

Track the project, not the market. Construction milestones and the district's delivery cluster say more about an owner's exposure than a citywide forecast.

Confirming what a property can carry takes a valuation and a document review, and both are easier while a handover date is still months away than in the week it lands. NEMAX reviews the property and confirms what it can support at handover, so a moved date costs time rather than the deal.

See what your property can support →

FAQ

How common are handover delays in Dubai?

Common enough to be the base case. Across 2025 and the first half of 2026, roughly 41% to 42% of homes scheduled for delivery in a quarter actually arrived in it, and the annual rate for 2025 was 48.9%.1 4 Most homes arrive later than announced rather than never.

How many homes will Dubai actually deliver in 2026?

About 110,500 completions were projected for 2026. Based on historical delivery rates, the realistic range is 33,000 to 50,000.4 The first half produced 24,800.3

What happens if my Dubai developer delays handover?

The standard sale-and-purchase agreement generally allows a grace period of up to twelve months past the announced completion date before a buyer's formal remedies become available.5 Your payment obligations do not disappear during that window, they move with it, which is the part most buyers plan for last.

Can I get a mortgage if my handover date keeps moving?

A bank approval is issued against a valuation and an expected completion date, so a significant shift usually means going through the process again. Owners who want certainty before the date is fixed often look at asset-backed co-financing instead, since it is assessed against the property rather than a delivery schedule.

Is Dubai oversupplied in 2026?

On paper the pipeline looks large. In practice roughly 40% of it arrives on schedule, which is why the market has absorbed successive "oversupply" forecasts without the correction they implied. Prices are flat to slightly down rather than falling sharply: up 1.9% year on year, down about 2.5% quarter on quarter.3

Handover schedules slip, payment schedules do not

The delivery rate has not moved in a year, and it is unlikely to move next year either. What has changed is the scale of the pipeline behind it and the price of exiting a deal at the wrong moment. An owner who treats handover liquidity as a standing line item, rather than an emergency, keeps the asset and the deadline.

Sourcing these deals for clients rather than doing them yourself? Advisers can submit a deal or partner with NEMAX.

Work with NEMAX

Have the Capital Ready Before the Date Moves

Handover schedules slip. Payment schedules do not. NEMAX reviews the property and confirms what it can support at handover, so an owner meets the deadline without selling the asset to make it.

Apply for capital →
*Indicative only, confirmed after valuation and due diligence. For information only, not financial or legal advice, and not an offer or commitment. All co-financing is subject to property review, valuation, due diligence, and legal documentation; final terms depend on the specific property, structure, and risk assessment. NEMAX structures asset-backed co-financing secured by real estate and does not operate as a retail bank.
Sources
  1. Q3 2025: 9,400 completions against 22,800 scheduled (41.3%), average construction cycle about 880 days in 2025 versus 1,180 in 2024 and 1,340 in 2023, sales prices up 4.5% quarter on quarter and 16.1% year on year. Cavendish Maxwell / Property Monitor, Dubai Residential Market Performance Q3 2025, reported via PropertyNews.ae. propertynews.ae →
  2. Q1 2026: 12,900 completions, up 23.1% year on year, against 30,300 projected, a materialisation rate of 42.3%. Cavendish Maxwell, Dubai Residential Market Performance Q1 2026. cavendishmaxwell.com →
  3. H1 2026: 24,800 homes delivered (up 37.6%), 41.3% of scheduled units, apartments 18,900 and villas or townhouses 5,900, 47,000 scheduled for H2 2026 against an expected 14,000 to 23,500, 28,000 units launched across 124 projects versus 102,000 across 410 a year earlier, 79,300 transactions worth AED 221.4 billion, off-plan share 74.8%, bank-credit deals 22,500 worth AED 51.3 billion (up 17.4%), prices AED 1,639 per square foot (up 1.9% year on year, down 2.5% quarter on quarter), rents up 7.8%, six communities holding about 37% of H2 scheduled completions. Cavendish Maxwell, reported by Khaleej Times and Zawya. khaleejtimes.com → zawya.com →
  4. Full year 2025: 40,400 homes completed against an initial projection of 82,600 (48.9%), up 16.4% on the 34,700 delivered in 2024, apartments 32,500 and villas or townhouses 7,900, with 110,500 units projected for 2026 against an expected 33,000 to 50,000. Cavendish Maxwell, Dubai Residential Market Performance FY 2025, published 16 February 2026. cavendishmaxwell.com →
  5. Dubai sale-and-purchase agreement practice: the standard RERA template allows developers a grace window of up to twelve months beyond the announced completion date before a buyer's remedies open. joinoliva.com →
